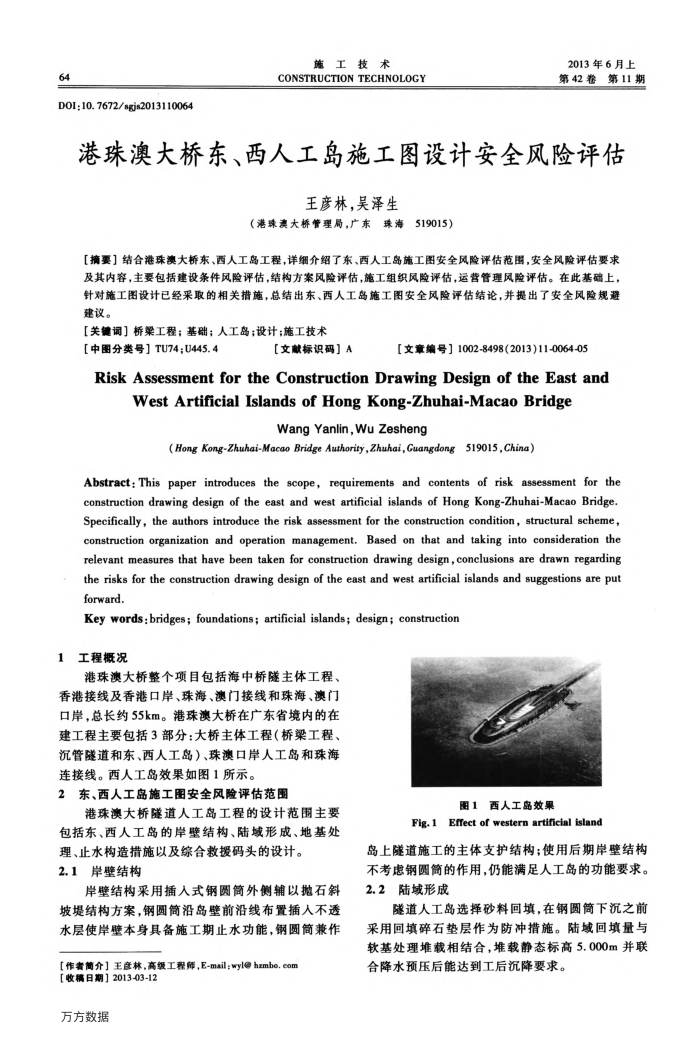

港珠澳大桥东、西人工岛施工图设计安全风险评估
王彦林,吴泽生
(港珠澳大桥管理局,广东珠海519015)
【及其内容,主要包括建设条件风险评估,结构方案风险评估,施工组织风险评估,运营管理风险评估。在此基础上针对施工图设计已经采取的相关措施,总结出东、西人工岛施工图安全风险评估结论,并提出了安全风险规避建议。
【关键词】桥架工程;基础;人工岛;设计;施工技术
【中图分类号】TU74;U445.4
【文献标识码】A
【文章编号】1002-8498(2013)11-0064-05
RiskAssessmentfortheConstructionDrawingDesignoftheEastand
West ArtificialIslands of HongKong-Zhuhai-MacaoBridge
Wang Yanlin,Wu Zesheng
(Hong Kong-Zhuhai-Macao Bridge Authority,Zhuhai,Guangdong519015,China)
Abstract: This paper introduces the scope, requirements and contents of risk assessment for the construction drawing design of the east and west artificial islands of Hong Kong-Zhuhai-Macao Bridge. Specifically, the authors introduce the risk assessment for the construction condition, structural scheme, construction organization and operation management. Based on that and taking into consideration the relevant measures that have been taken for construction drawing design,conclusions are drawn regarding the risks for the construction drawing design of the east and west artificial islands and suggestions are put forward
Key words:bridges; foundations; artificial islands; design; construction
1工程概况
港珠澳大桥整个项目包括海中桥隧主体工程、香港接线及香港口岸、珠海、澳门接线和珠海、澳门口岸,总长约55km。港珠澳大桥在广东省境内的在建工程主要包括3部分:大桥主体工程(桥梁工程、沉管隧道和东、西人工岛)、珠澳口岸人工岛和珠海连接线。西人工岛效果如图1所示。
东、西人工岛施工图安全风险评估范围 2
港珠澳大桥隧道人工岛工程的设计范围主要包括东、西人工岛的岸壁结构、陆域形成、地基处
理、止水构造措施以及综合救援码头的设计。 2.1岸壁结构
岸壁结构采用插人式钢圆筒外侧辅以抛石斜坡堤结构方案,钢圆筒沿岛壁前沿线布置插人不透水层使岸壁本身具备施工期止水功能,钢圆筒兼作
【作者简介】王彦林,高级工程师,E-mail:wyl@hzmbo.com
【收稿日期】2013-03-12 万方数据
图1西人工岛效果
Fig.1 Effect of western artificial island
岛上隧道施工的主体支护结构;使用后期岸壁结构不考钢圆筒的作用,仍能满足人工岛的功能要求。 2.2陆域形成
隧道人工岛选择砂料回填,在钢圆筒下沉之前采用回填碎石垫层作为防冲措施。陆域回填量与软基处理堆载相结合,堆载静态标高5.000m并联合降水预压后能达到工后沉降要求。
