Key words : bridges; steel box tied arch bridge; ectopic assembly ; pushing operation; construction 1工程概况
湟水河大桥工程位于青海省海东市乐都区,是当地城市路网规划中跨越湟水河的南北向独立桥梁,采用1-130m下承式提篮形钢箱系杆拱桥(见图 1),钢结构共2620t,桥宽36.0m,梁高3m,拱肋矢高 29m,内倾15°,按照抛物线结构设置。桥梁全长 141.0m,道路设计等级为城市主干道。主桥钢结构
主要包括拱肋系统及主梁两部分。 2总体方案概述
本桥主要以“异位拼装,带拱顶推”的施工工艺进行安装架设施工。钢拱桥单元件在厂内制作并进行预拼装,经检验合格后的梁段通过公路运输至桥址,进行二次拼装。具体为在0号桥台的引道路基上设置桥梁组装胎架;在胎架上组装桥梁上部钢
【作者简介】王栋,工程师,E-mail:56054270@qq.com【收稿日期]方数据

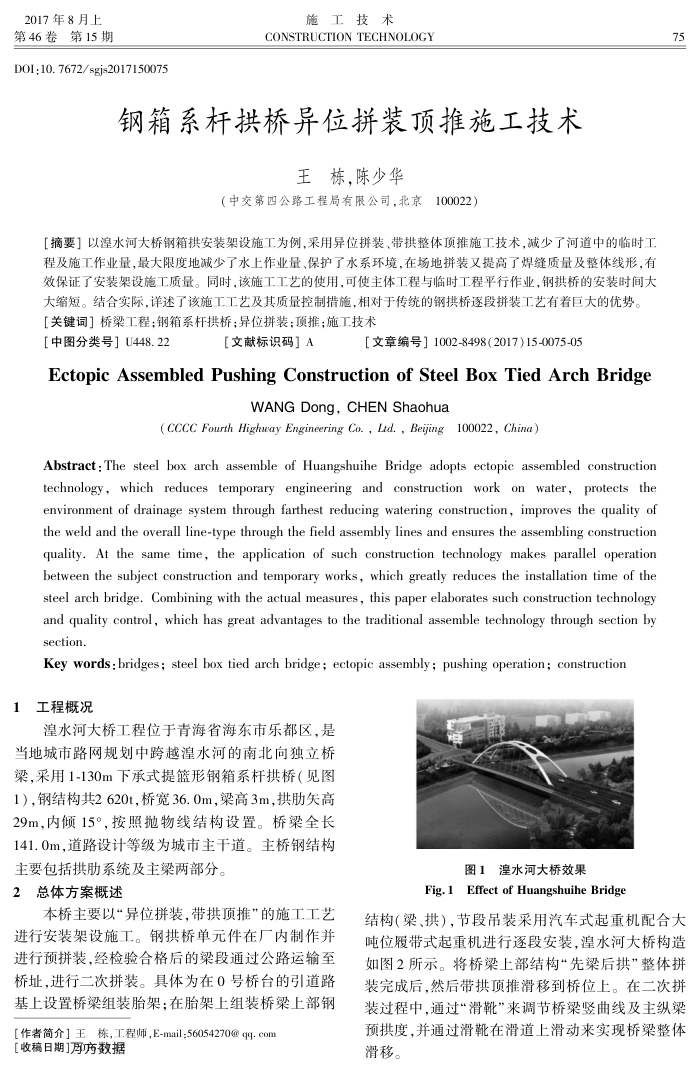

图1湟水河大桥效果
Fig.1 Effect of Huangshuihe Bridge
75
结构(梁、拱),节段吊装采用汽车式起重机配合大吨位履带式起重机进行逐段安装,湟水河大桥构造如图2所示。将桥梁上部结构“先梁后拱”整体拼装完成后,然后带拱顶推滑移到桥位上。在二次拼装过程中,通过“滑靴”来调节桥竖曲线及主纵梁预拱度,并通过滑靴在滑道上滑动来实现桥梁整体滑移。
