2015年12月上第44卷第23期
DOI:10.7672/sgjs2015230105
施工技术
CONSTRUCTION TECHNOLOGY
印度德里Wazirabad大桥钢塔大端面机加工工艺研究
陈小松,杨元录
(江苏中泰桥梁钢构股份有限公司,江苏靖江214521)
【摘要】钢塔节段采用精确调整设备、高精度测量备、高精度机加工设备进行精确定位、测量、机加工,并通过数理模型拟合进行数据处理,控制塔段机加工尺寸精度;钢塔预拼装通过建立微型测量控制网,采用全站仪进行三维
数据测量,通过实测与理论数据模型比对控制钢塔节段整体线形和尺寸精度。【关键词】桥梁工程;斜拉桥;钢塔;端面;机加工;拼装
【中图分类号】U443.38
【文献标识码】A
【文章编号】1002-8498(2015)23-0105-03
LargeEndSurfaceMachiningResearchofWazirabadBridge
Steel Tower in Delhi of India
ChenXiaosong,YangYuanlu
(Jiangsu Zhongtai Bridge Steel Structure Co.,Lad.,Jingjiang,Jiangsu 214521,China)
Abstract:Steel tower segment uses precise adjustment equipment, high precision measurement equipment, high-precision machining equipment for precise positioning, measurement and machining Meanwhile, the mathematical model fitting is applied for data processing and controlling-tower section aaaaseee measurement of the micro control network, the use of precision measuring instruments and three-dimensional measurements, and the comparison of measured data and the theoretical data to control the overall linear and dimension precision of the steel tower.
Key words:bridges; cable stayed bridges; steel towers; ending surface; machining; assembly 工程概况
印度德里Wazirabad大桥为独塔钢-混凝土叠合梁斜拉桥,钢塔高约151m。主桥钢塔共分4大部分:塔基、塔腿、塔身、塔头。钢塔为栓焊结构。钢塔节段之间进行全断面机加工顶紧后栓接,全桥端面机加工和钻孔工作量大且精度高。如图1所示。
2钢塔大端面机加工难点及采取的工艺措施 2.1钢塔大端面机加工难点
1)塔腿和塔身结合部由5个节段在高度方向通过贴合板相连接后,在前索区侧形成折线形端面与塔身相连,折线形端面机加工精度控制是制造的重点和难点。如图2所示。
2)塔身节段间全端面最大尺寸:17.8mx 37.4m,为“V"字形端面,工艺上需分为2次机加工,机加工面需要进行复位接刀,端面有2640个螺栓连接孔在端面机加工完成后再钻孔。端面平面度、【作者简介】陈小松,高级工程师,E-mail;1016183532@qq.com
[收稿日期】2014-11-05 万方数据
塔头
A轴塔身 A轴塔膜
锅梁A轴塔基
B轴塔身梦器合 B轴塔腿
B轴塔基后错固区

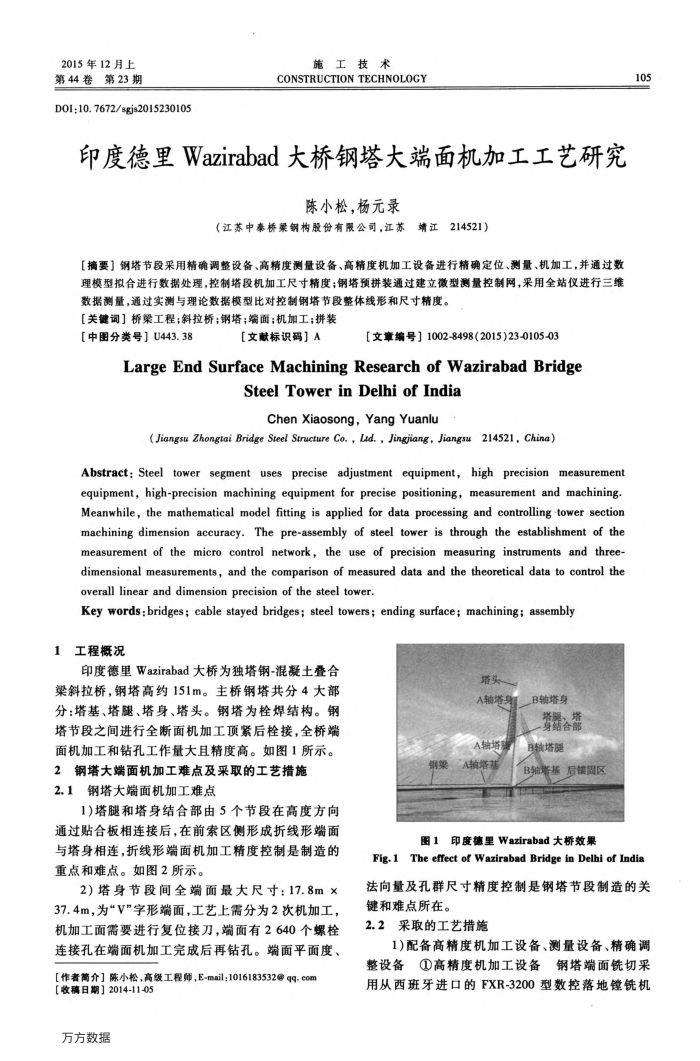

图1印度德里Wazirabad大桥效果
105
Fig.1 The effect of Wazirabad Bridge in Delhi of India 法向量及孔群尺寸精度控制是钢塔节段制造的关键和难点所在。
2.2采取的工艺措施
1)配备高精度机加工设备、测量设备、精确调整设备①高精度机加工设备钢塔端面铣切采用从西班牙进口的FXR-3200型数控落地镗铣机
